play icon for videos
← Academy
SOPACT ACADEMY · IMPACT MEASUREMENT · EMBED

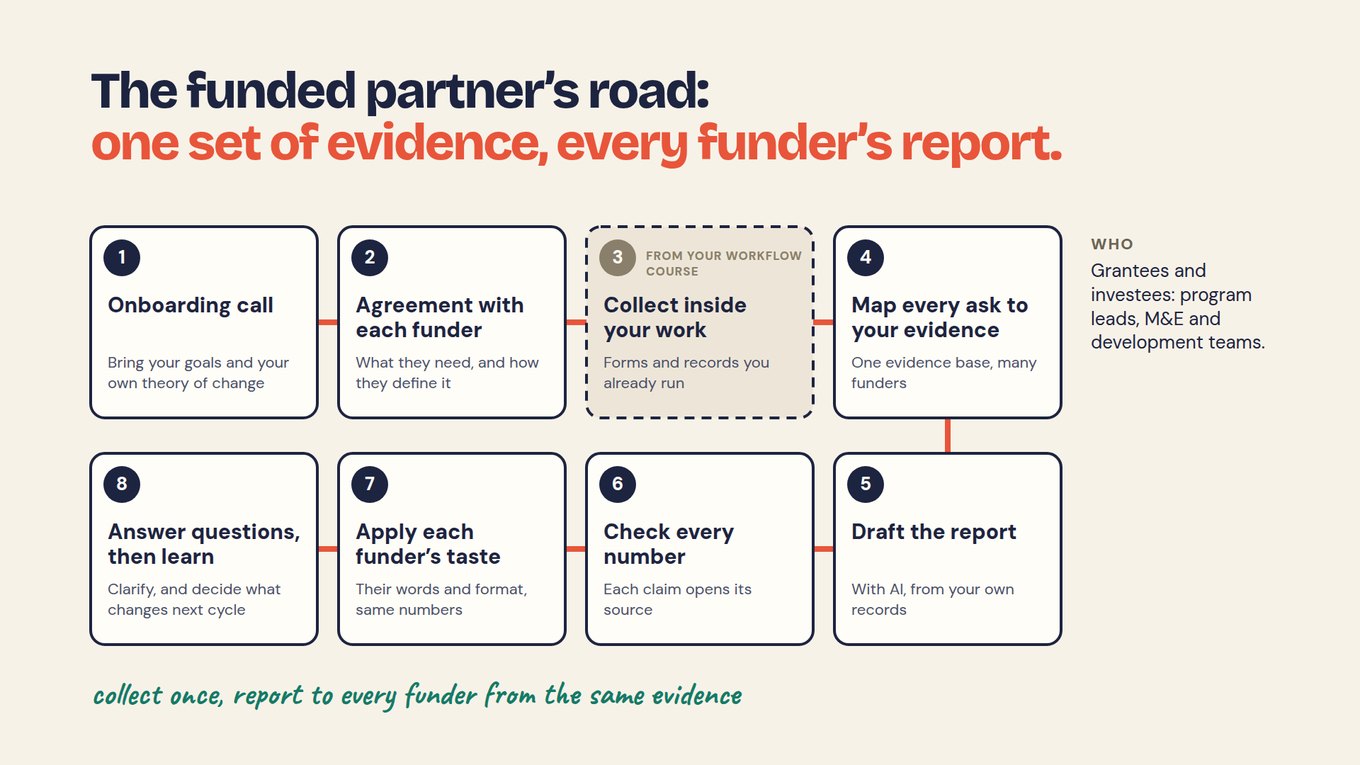

How Do You Collect Clean Evidence Inside the Workflow?

Clean evidence is not just valid form data. Place each requirement inside the moment it naturally appears, connect it to context and action, and follow what happens next.

To collect clean evidence inside the workflow, assign every item in your Reporting-to-Evidence Map to the moment when it can be observed accurately and used. Define the minimum signal, the context needed to interpret it, the person responsible, the identity and timestamp that connect it to later records, the action it can trigger, and the follow-up that shows what changed. Clean evidence is not merely a validated form. It is evidence captured close enough to the work that the team can still respond.

This lesson is for program, MEL, grant, foundation, portfolio, and data leads who already know what evidence they need from Chapter 6. You will turn that map into a Collection-Moment Plan that works across enrollment, attendance, service delivery, follow-up, interviews, case notes, partner documents, and emails.

What you will produce

  • A natural collection moment for every required evidence item.
  • A minimum operational signal plus a neutral context question where the signal cannot explain itself.
  • An owner, timestamp, identity rule, validation rule, and action trigger.
  • A follow-up event that shows whether the program response helped.

How do you turn an evidence map into a collection workflow?

  1. Start with a decision. Take one row from Chapter 6 and state what someone could decide if the evidence arrived on time.
  2. Choose the natural moment. Place the evidence at enrollment, first service, completion, follow-up, interview, case action, partner submission, or document review.
  3. Capture the minimum signal. Record the smallest observable event or value that answers the operational question.
  4. Add context only where needed. Use one neutral open question, an interview, a note, or a source document when a number cannot explain why it changed.
  5. Connect and govern the record. Preserve person or entity, source, timestamp, stage, consent/access, validation, and review status.
  6. Define action and follow-up. Decide who sees the signal, what they can do, and which later record shows whether the response worked.

What does “clean evidence at the source” actually mean?

In short: Evidence is clean at the source when its meaning, identity, timing, and provenance are correct at the moment it is created. Valid dates and allowed values matter, but they are only one part. A perfectly formatted attendance record is still weak evidence if it is attached to the wrong participant, entered weeks late, or cannot be linked to the staff response that followed.

Chapter 6 becomes Chapter 7
Reporting-to-Evidence Map
What must be known, which approved measure answers it, and what evidence could support it.
Collection-Moment Plan
When it appears → what is captured → who reviews it → what action follows.
Live evidence loop
Signal, context, program response, and follow-up remain connected over time.

This distinction changes the design question. Do not ask, “Which survey should we send?” Ask, “At which moment could we observe this evidence with the least burden and still do something useful with it?” Sometimes the answer is a form. It may also be an attendance event, an existing case note, an employer email, a partner PDF, a short interview, or an action already recorded by staff.

Use Moment → Signal → Context → Action → Follow-up

In short: Every collection design should connect five different jobs. The moment says when evidence appears. The signal says what happened. Context explains what the signal cannot. Action records the program response. Follow-up shows whether the situation changed.

01 · Moment
When can this be observed naturally?
02 · Signal
What is the minimum event or value?
03 · Context
What do we need to understand why?
04 · Action
Who responds, how, and by when?
05 · Follow-up
What later evidence shows change?

These parts should not be collapsed. Attendance is a signal, not an explanation. A participant statement is context, not automatically a metric. A referral is a program action, not proof that the problem was resolved. A later attendance event may show re-engagement, but it does not by itself prove why the change occurred.

Worked example: youth enroll but do not attend the first session

In short: Enrollment alone can hide the earliest point of disengagement. Record first-session attendance as a separate event, ask a neutral question when a young person does not attend, connect the answer to a staff response, and observe whether the person joins a later session.

In Sopact’s work with Open Play Foundation in Stellenbosch, South Africa, Marco Botha described an important operational problem: enrollment did not necessarily lead to participation. Young people could enroll and then not appear for the first session. Program information had been collected diligently, but when analysis arrived weeks later it behaved like a postmortem: the team could see that participation had fallen, but not respond at the moment of risk or understand why.

The mistake would be to begin with a long barrier survey or assume that the cause was fees. Transport, care responsibilities, safety, timing, family expectations, confidence, health, or something the team has not considered may matter. The first useful question is deliberately open:

One neutral context question
“What, if anything, made it difficult for you to attend the first session?”
It does not presume that a barrier existed or tell the young person which explanation the program expects.

Preserve the exact response. AI or a human may later code recurring themes, but the theme must remain connected to the source words. Do not infer a sensitive circumstance that the participant did not state. In this example, staff can follow up through WhatsApp to understand whether financial hardship—or another barrier the young person identifies—made attendance difficult. The evidence supplied does not establish what financial support, if any, was offered, so the article should not imply that assistance was promised.

Part Proposed evidence What it can tell the team What it cannot prove
MomentFirst scheduled sessionThe earliest planned participation pointWhether enrollment reflected commitment or access
SignalAttended / did not attend / attendance not recordedWho may need timely follow-upWhy someone was absent
ContextExact response to the neutral questionThe participant’s stated experienceA diagnosis or complete causal explanation
ActionWhatsApp outreach to understand the barrier, including possible financial hardship; owner and date recordedHow the program followed upThat financial support was offered or that the outreach resolved the barrier
Follow-upAttended a later session, remained unreachable, declined, or exitedWhat happened after the responseThat the program alone caused the later outcome

Example boundary: The table translates the field experience into a reusable collection design; it is not a reproduction of Open Play’s complete metric set. The account confirms WhatsApp outreach to understand possible financial hardship, but does not establish that financial assistance was offered.

Why do you need quantitative, qualitative, and longitudinal evidence together?

In short: Quantitative evidence identifies the pattern, qualitative evidence helps explain the participant’s experience, program records show the response, and longitudinal evidence shows what happened next. None should impersonate the others.

Pattern
Quantitative: enrollment, attendance, completion, follow-up status.
Experience
Qualitative: participant words, interview, observation, case note.
Response
Operational: contact, referral, schedule change, owner, date.
Change over time
Longitudinal: first session → response → later participation.

This also reduces survey burden. Do not ask participants to repeat information that already exists in attendance, case, partner, or document records. Ask only for evidence that the workflow cannot observe—especially the person’s experience, priorities, and interpretation. A short, well-timed question can be more useful than a long end-of-program survey that arrives after the opportunity to help has passed.

Can clean evidence reveal a problem you did not plan to measure?

In short: Yes. A useful evidence workflow must preserve unexpected observations, not only answers to predetermined metrics. The observation needs a source, place, timestamp, owner, response, and resolution status so that it becomes actionable rather than disappearing inside a message or someone’s memory.

Botha also reported that ongoing collection surfaced a water leak in a program setting. A water leak is not an outcome indicator, yet it can affect safety, program delivery, cost, and attendance. If the system accepts only the metrics selected at the start, this kind of operational evidence can remain buried until it becomes a larger problem.

Unexpected evidence
A water leak is observed or reported at a program site.
Make it traceable
Retain the description, source, location, time, and any supporting image or note.
Close the loop
Assign an owner, record the response, and verify whether the issue was resolved.

The point is not to add “number of water leaks” to the theory of change. It is to connect field intelligence to action. Metrics describe expected signals; open text, observations, interviews, messages, and documents preserve what the team did not know to ask. Both belong in the same governed evidence workflow.

What belongs in a Collection-Moment Plan?

In short: For each evidence requirement, document the natural moment, minimum signal, context source, identity and timestamp, owner, validation, action threshold, access rule, and follow-up. If nobody will review or act on the evidence, question whether it should be collected.

Evidence requirement Moment Signal / context Identity + time Owner + validation Action + follow-up
First-session participationFirst scheduled sessionAttendance status; neutral question if absentParticipant ID; session ID; event timeFacilitator; separate “not recorded” from “absent”WhatsApp follow-up; observe next attendance
Participant barriersWhen risk appears—not only at exitExact words; confirm whether financial hardship or another barrier appliesParticipant ID; WhatsApp source; response timeAssigned staff; source text retainedDocument outreach and later status; do not imply unconfirmed assistance
Unexpected site conditionWhen observed during program deliveryExact observation; supporting note or image if availableSite; source; observation timeAssigned owner; validate location and current statusRecord response and verify resolution
Partner delivery evidencePartner’s normal reporting or service eventStructured values plus source documentPartner; site; period; upload datePartner owner; completeness and definition checkMissing-evidence alert; next partner review

How do you keep collection useful without overloading staff and participants?

In short: Reuse evidence already created by the work, collect only what can change a decision or satisfy a justified requirement, and place each question with the person and moment best able to answer it. More fields do not create more insight.

  • Do not duplicate operational evidence. If attendance already exists, link it; do not ask the participant to report it again.
  • Do not collect context from the wrong person. Staff can record an action; participants should describe their own experience.
  • Do not ask too early or too late. Baseline belongs before the service can affect the measure; a barrier question belongs when the barrier becomes visible.
  • Do not force narrative into a number. Keep exact text, approved codes, and AI interpretation separate.
  • Do not confuse missing with negative. “Attendance not recorded,” “did not attend,” “declined to answer,” and “unreachable” are different states.
  • Do not create an alert without an owner. A risk signal needs a responsible person, response window, and documented resolution.

Prompt: turn the evidence map into a Collection-Moment Plan

You are preparing a DRAFT Collection-Moment Plan for human approval. INPUTS 1. Approved Reporting-to-Evidence Map 2. Approved Metric Definition Sheets 3. Actual workflow stages and staff roles 4. Existing forms, attendance records, case notes, emails, interviews, partner reports, and documents 5. Consent, privacy, access, retention, and safeguarding rules FOR EACH EVIDENCE REQUIREMENT RETURN - Decision the evidence supports - Natural collection moment - Minimum quantitative or documentary signal - Neutral context question or source, only where needed - Person/entity ID, source ID, program stage, and timestamp - Owner and collection channel - Validation and missing-state rules - Access and consent rule - Action trigger, reviewer, and response window - Follow-up evidence and review cadence RULES - Reuse existing evidence before creating a new question. - Never assume the cause of a signal; use neutral wording. - Keep participant words, approved codes, staff actions, and AI interpretations separate. - Do not infer sensitive attributes or convert narrative into an unsupported number. - Distinguish absent, not recorded, declined, not applicable, and unreachable. - Flag any evidence with no decision, owner, or justified reporting requirement as REMOVE OR JUSTIFY. - Mark uncertain items NEEDS HUMAN REVIEW. OUTPUT 1. Collection-Moment Plan 2. Questions or fields to remove 3. New collection or integration work required 4. Alerts and actions requiring an owner 5. Privacy, consent, or safeguarding decisions

Where can AI help—and where must people decide?

In short: AI can validate formats, connect records, classify candidate themes, summarize evidence with citations, and flag missing or contradictory records. People decide what to ask, whether a theme is valid, what action is appropriate, and how participant rights are protected.

AI can assist
  • Check types, required values, duplicates, and missing states
  • Connect evidence using approved identity rules
  • Propose themes while preserving exact source text
  • Flag a no-show, missing partner file, or contradictory record
  • Draft a cited summary from approved evidence
People remain responsible
  • Approve the question and collection moment
  • Confirm the meaning of a qualitative theme
  • Choose an appropriate program response
  • Review sensitive or high-stakes interpretations
  • Set consent, access, retention, and safeguarding rules

Where does Sopact Sense help?

A small team can maintain a Collection-Moment Plan in a spreadsheet and use its existing forms and folders. Friction grows when evidence arrives through many channels, the same participant or partner appears across records, open text accumulates unread, partners use different definitions, and nobody sees a gap until reporting begins.

Sopact Sense can connect forms, attendance, interviews, case notes, emails, spreadsheets, and partner documents to the approved evidence structure. It can analyze new evidence on arrival, preserve the source behind each result, flag missing or contradictory records, and let teams ask questions across quantitative, qualitative, and longitudinal evidence. Staff validate themes, approve actions, and retain final authority.

For decisions affecting people, test collection and analysis across languages and access needs, document overrides, restrict sensitive records, establish retention rules, and monitor whether alerts or classifications affect groups differently. Faster evidence is useful only when it remains responsible and reviewable.

Frequently asked questions

How do you collect clean evidence inside a program workflow?

Start with a justified evidence requirement, place it at the moment it naturally appears, capture the minimum signal, add neutral context only when needed, and preserve identity, source, stage, timestamp, consent, and validation. Assign an owner and action trigger, then identify the later evidence that shows what happened after the response.

Is clean data at the source just form validation?

No. Form validation prevents invalid types and values, but clean evidence also requires the correct definition, participant or entity, source, collection moment, timestamp, missing-state rule, and provenance. Evidence can be technically valid yet operationally useless if it arrives too late or cannot be connected to an action and follow-up.

What is a collection moment?

A collection moment is the point in real work when evidence can be observed with the least distortion and burden—for example application, enrollment, first session, service delivery, completion, follow-up, interview, case action, partner submission, or document review. It is more specific than choosing a survey frequency.

How do you ask why someone did not attend without leading them?

Begin with neutral wording such as, “What, if anything, made it difficult for you to attend?” Do not assume the barrier was fees, transport, safety, motivation, or another expected category. Preserve the exact answer; confirm a structured category only when required for action or analysis.

Should every metric have an open-ended question?

No. Add qualitative context when the signal cannot answer a decision-relevant “why,” when participant experience is itself required evidence, or when the team needs to design an appropriate response. Routine operational events may need no extra question. Repeated unnecessary questions create burden and weaker answers.

How do you connect the same person across enrollment and follow-up?

Use one governed participant identifier across events and keep event-specific identifiers and timestamps for each collection moment. Define duplicate resolution, consent, access, and identity-correction rules. Do not rely on approximate name matching as the normal method, especially when records affect services or reporting.

Can emails, case notes, and partner PDFs be collected as evidence?

Yes. Preserve the source, author or organization, date, reporting period, relevant entity, access rule, and citation. Extracted values or themes should link back to the document passage. A file’s existence does not make every statement accurate, comparable, or sufficient; validation and human review still apply.

What happens after the Collection-Moment Plan is operating?

Test whether the same governed evidence produces stable results across repeated analyses. Review missingness, duplicates, definition drift, coding changes, late entries, and contradictory sources. Chapter 8 shows how to control those conditions so a result does not change merely because a different person prepared the report.

Sources and example boundaries

  • Open Play Foundation — public organization and program context.
  • The first-session, WhatsApp, possible-financial-hardship, and water-leak observations come from a field account shared by Marco Botha through Sopact’s work with Open Play. The table fields are a reusable design derived from that account, and the article makes no claim that financial assistance was offered.

Next: Your evidence is now captured with a governed definition, source, identity, timestamp, and collection moment. Chapter 8 shows how to keep the analysis stable in How Do You Get the Same Numbers Every Time? →

Ready to try it for yourself?

ChatGPT, Claude, and Gemini are fine for a quick test — but not for an answer you'll put in front of a funder or board. When it has to hold up, run it in Sopact Sense.
